Steel Structure Shipping & Logistics: International Buyer Guide

Container vs break-bulk shipping, port handling, customs clearance, packing specs and cost optimization for steel structures shipped from China to your project site.

Steel Structure Shipping & Logistics: International Buyer Guide

Steel structures are heavy, oversized, and complex to ship. A warehouse that costs $80,000 to fabricate can cost $15,000-$30,000 to deliver โ€” and if logistics are mismanaged, delays and damage can double those costs.

Understanding how steel structures are shipped from China to your destination is essential for accurate budgeting, realistic timeline planning, and avoiding costly surprises at the port.

This guide covers everything international buyers need to know about steel structure logistics, from factory loading to final delivery.

Two Shipping Methods: Container vs Break-Bulk

FactorContainer ShippingBreak-Bulk Shipping
Best forSmall to medium projects (under 50 tons)Large projects (50+ tons)
LoadingMembers cut to fit 20ft or 40ft containersLoose on vessel, craned onboard
Cost per ton$100-$200/ton higher$80-$150/ton (more economical for large volumes)
Transit time15-30 days (scheduled sailings)20-45 days (subject to vessel availability)
Damage riskLower (enclosed container)Higher (exposed to weather)
Port requirementsStandard container portHeavy-lift crane or mobile crane required
Customs clearanceStraightforwardMay require additional documentation

Container Shipping

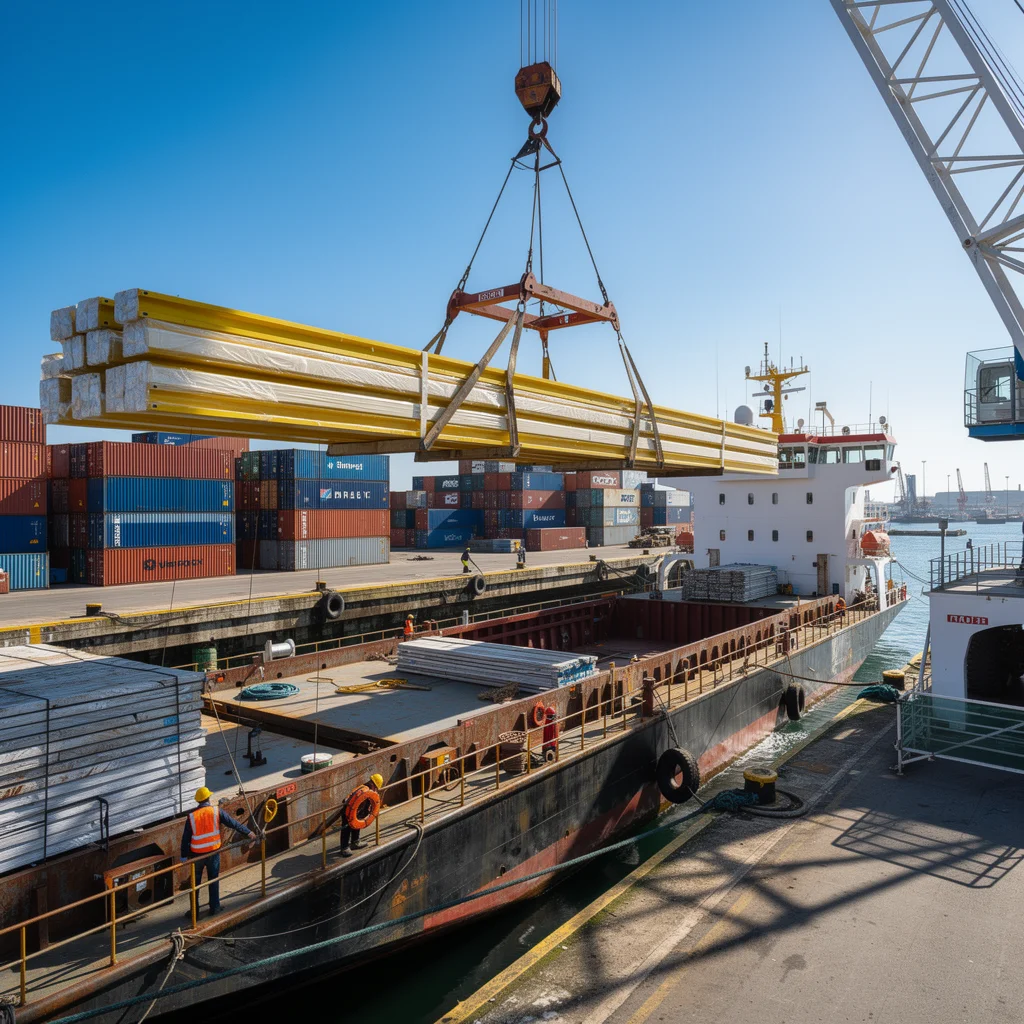

International shipping port crane loading steel beams onto cargo vessel
International shipping port crane loading steel beams onto cargo vessel

Most small to medium steel structure projects (under 50 tons) ship in standard 40ft open-top or flat-rack containers. Long members (columns, rafters) are cut into manageable lengths and spliced on site with bolted connections.

Typical container loading:

  • 40ft open-top container โ€” for beams, columns, purlins (27-28 tons max)
  • 40ft flat-rack container โ€” for wide or tall assemblies (30-35 tons max)
  • 20ft container โ€” for small projects, accessories, bolts, and cladding

Break-Bulk Shipping

For projects over 50 tons, break-bulk shipping is more economical. The entire steel frame is loaded as loose cargo directly onto the vessel. This requires:

  • A port with heavy-lift crane capacity
  • Proper lashing and securing by stevedores
  • Weather protection for sensitive items (bolts, electrical components)
> Laotie Steel tip: We recommend containers for projects under 100 tons to your site. For projects over 100 tons, break-bulk becomes significantly more cost-effective.

Shipping Cost Breakdown

A typical shipping cost for a steel structure from China to various destinations:

Destination40ft ContainerPer Ton (Container)Per Ton (Break-Bulk)Typical Transit
Philippines (Manila)$2,500-$3,500$90-$125$70-$1007-12 days
Vietnam (Ho Chi Minh)$1,500-$2,500$55-$90$45-$705-8 days
Indonesia (Jakarta)$2,000-$3,000$70-$110$55-$8510-15 days
Thailand (Bangkok)$1,800-$2,800$65-$100$50-$808-12 days
Nigeria (Lagos)$5,000-$7,000$180-$250$140-$20025-40 days
Saudi Arabia (Dammam)$3,000-$4,500$110-$160$85-$13020-30 days
Australia (Sydney)$4,000-$6,000$140-$210$110-$17015-25 days
*Prices are estimates and subject to market fluctuations. Get a current quote from Laotie Steel.*

Packing and Protection

Proper packing prevents corrosion and damage during transit, especially on long sea voyages through tropical climates.

Standard packing for steel structures:

  • Rust-proof primer: All steel members coated with zinc-rich epoxy primer (minimum 80 microns)
  • Edge protection: Plastic or rubber edge protectors on all cut ends
  • Strapping: Steel bands every 2-3 meters for bundled members
  • Waterproof wrapping: For bolt kits, connection plates, and small accessories
  • Desiccant packs: Inside container for moisture absorption
  • Lashing: Chains or steel cables securing the load to container corner castings
> Important: Specify marine-grade packing in your contract. Some manufacturers use cheaper packing that fails in high-humidity environments.

Documentation

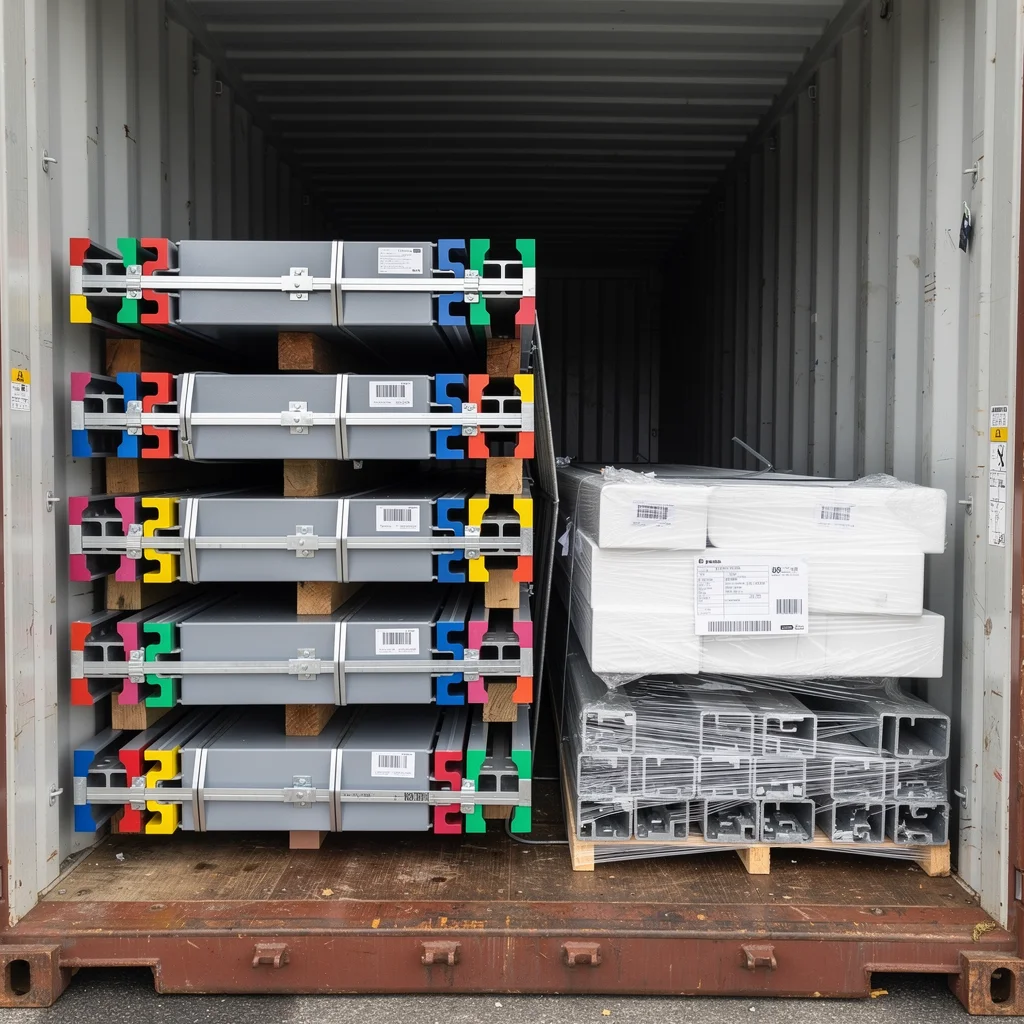

Steel beams professionally packed and strapped inside shipping container for export
Steel beams professionally packed and strapped inside shipping container for export

Required for Customs

Complete and accurate documentation prevents customs delays and additional charges. Here is what you need:

DocumentPurposeProvided By
Bill of Lading (B/L)Proof of ownership and transport contractShipping line
Commercial InvoiceValue declaration for customsSeller
Packing ListItemized contents per containerSeller
Certificate of OriginProves country of manufactureChamber of Commerce
Mill Test CertificatesSteel grade and chemical compositionSteel mill
Insurance CertificateCovers loss or damage during transitBuyer or seller
Import PermitRequired in some countriesBuyer
HS Code for steel structures: 7308.90 โ€” Structures and parts of structures, of iron or steel.

Lead Times: From Factory to Site

Understanding the full timeline helps you plan your construction schedule accurately.

StageDurationNotes
Engineering and design1-3 weeksDepends on complexity and code requirements
Material procurement1-2 weeksSteel coil and plate sourcing
Fabrication2-5 weeksCutting, welding, drilling, assembly
Surface treatment3-5 daysShot blasting, priming, painting
Packing and loading2-4 daysContainer stuffing or vessel loading
Sea freight5-40 daysDepends on destination
Customs clearance2-7 daysVaries by country
Inland transport1-5 daysPort to project site
Total5-10 weeksFrom order to site arrival

5 Tips to Reduce Shipping Costs

1. Optimize member lengths โ€” Design columns and beams to fit standard container lengths (12m for 40ft containers). Every extra meter costs significantly more.

2. Consolidate shipments โ€” Combine multiple small projects into one shipment to get better per-ton rates.

3. Use flat-rack containers for wide items โ€” Open-top containers can handle taller loads but flat-racks accommodate wider assemblies.

4. Book early โ€” Container freight rates fluctuate with demand. Booking 3-4 weeks ahead can save $500-$1,000 per container.

5. Consider FOB vs CIF โ€” FOB (Free on Board) gives you control over freight arrangements; CIF (Cost, Insurance, Freight) lets the seller handle logistics. Compare total costs before deciding.

Get a full logistics quote from Laotie Steel โ€” we provide both FOB and CIF pricing with real-time freight estimates.

Frequently Asked Questions

Q: Can I track my shipment? A: Yes. All container shipments have a container number and Bill of Lading number that can be tracked on the shipping line's website. Laotie Steel provides tracking information for every shipment.

Q: What happens if goods are damaged during shipping? A: If you purchased insurance, file a claim with photographic evidence. If not, damage claims must be made against the shipping line. Always inspect goods at the port before accepting delivery.

Q: Do I need to clear customs myself? A: Most buyers use a customs broker in their country. The broker handles documentation, duties, and taxes. Laotie Steel provides all required export documentation to support your clearance.

Q: How are steel structures protected from rust during ocean transit? A: All members receive shot blasting (SA 2.5 standard) followed by a rust-proof primer before packing. Additional protection includes edge protectors, steel strapping, and waterproof wrapping for sensitive items.

Conclusion

Shipping logistics for steel structures require careful planning, but with the right knowledge and a reliable manufacturer, the process is straightforward. Focus on proper packing, complete documentation, and realistic timeline expectations.

Planning a steel structure project? Contact Laotie Steel's logistics team for a detailed shipping plan and cost estimate tailored to your destination.

*Laotie Steel Structure Co., Ltd. โ€” Exporting to 30+ countries. Door-to-door logistics support available. Contact us for a free quote within 24 hours.*

Need a Steel Structure?

Get a free quote from our engineering team. We respond within 2 hours.

Request a Quote

Stay Updated

Get steel structure tips, cost guides, and industry insights delivered to your inbox.

No spam. Unsubscribe anytime.
